Behind the construction fences Construction details Technology Video

HB Nord – Glass Brick FaƧade Gleisarena

04.03.2020 / Schweiz / Christian Koehly
Building
construction
Overview

Factbox


Client: SBB AG

Contractor: PORR SUISSE AG

Architect: Made in SĆ rl, Genf

Contract Type: Totalunternehmer

Project Type: Building construction . Office

Scope: Planning and construction of a seven-storey head-end structure and a six-storey longitudinal building

Contract Volume: 40 million Swiss francs (35.9 million euros)

Construction Start: 05/2017

Construction End: 02/2020

The Gleisarena office complex, being planned and built by PORR next to Zurich’s central station, has a curved striking glass brick faƧade.

The new glass brick faƧade, implemented by PORR in collaboration with Alu Sommer, represents a true technological milestone. The double-skin faƧade uses standard glass bricks, joined together with a thermal barrier to form a 212mm thick element.

Glass bricks give any project a special aesthetic appeal. However, their considerable structural drawbacks often present significant challenges for planning and implementation, particularly in the light of rising standards for heat transfer and noise insulation.

The 1500m² façade on the Gleisarena office complex in Zurich was a major undertaking in any case due to its size, but the architects at Made in Sàrl added to this complexity by incorporating numerous curves in the façade design.

The challenges this presented were more than merely technical, as the faƧade is also subject to specific requirements under labour law, such as providing an unobstructed view to the outside.

In spring 2017, PORR was selected as the general contractor for implementation of the project. Working with its subsidiary Alu Sommer, PORR planned and built the faƧade in accordance with the architects’ specifications. The innovative structure made it necessary to develop similarly innovative transport methods and assembly techniques.

High degree of prefabrication

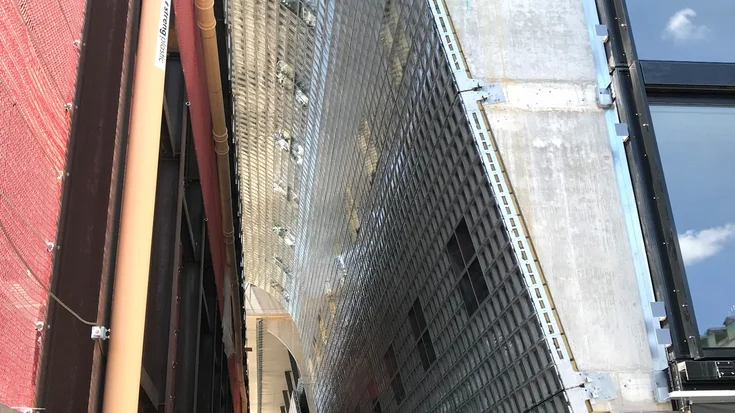

The cast glass elements were installed in stainless-steel grids in the factory. Source: PORR

The complete faƧade comprises a total of 24,000 cast glass bricks each measuring 240 x 240mm, with a thermal barrier. The stainless-steel profiles needed to secure the structure were prefabricated in the factory as 1.50m x 3.0m stainless steel grids. The height of these elements corresponds to the height of the storeys in the building. While still in the factory, the glass bricks were pasted into these elements with glue on all sides. In addition, 100,000 specially developed plastic brackets were pressed and installed between the glass bricks and the steel framework to prevent the bricks from falling out of the framework if the glue should fail.

The complete faƧade comprises a total of 24,000 cast glass bricks with a thermal barrier. The stainless steel profiles were prefabricated in the factory in stainless steel grids.

The faƧade was then mounted on the reinforced concrete building carcass. The carcass was fitted in advance with specially developed holders attached to Halfen channels installed on the front faces of the ceilings. The holders are special supports made of extrusion profiles that allowed for three-dimensional adjustment for fine-tuned positioning of individual elements. The elements were suspended on the built-in bolts using hooks on the rear side. This left assembly joints between the prefabricated elements at the heights of the ceilings, which were elastically jointed after installation.

High complexity, low tolerances

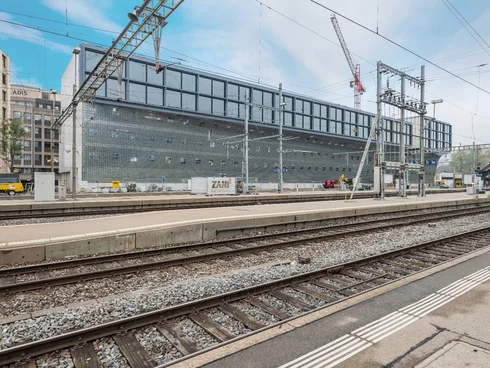

This side view shows the high geometric complexity of the glass brick faƧade. Source: PORR

With such complex geometry – an elliptical plan view, vertical inclination and a three-quarter circle formation above – tolerances were a minimal 1mm in each dimension. The support elements made it possible to reconcile this high degree of precision with the somewhat coarser carcass structure.

Alu Sommer developed a special measurement system for the faƧade to ensure the elements were adjusted correctly and engaged surveyors to assist with its implementation.

Since the glass brick faƧade extends over a number of storeys and neighbouring building elements, it was necessary to laminate wall and ceiling faces that would meet the inside of the faƧade.

This was achieved with reflective elements, which were also installed in the steeply arched overhanging sections of the faƧade. The reflective effect comes from the inner surface of the outer glass bricks.

Construction and structural design

Structurally, the glass brick faƧade is equivalent to a traditional hanging faƧade, suspended from the ceiling faces on each storey. The vertical load transfer for the dead weight takes place through the mounting elements in the reinforced concrete ceilings. Loads from wind pressure and wind suction are similarly transferred from the stainless steel grid to the ceilings, via the suspension points.

Elaborate construction process

Hoisting the elements into place proved particularly challenging due to the cramped conditions. Source: PORR

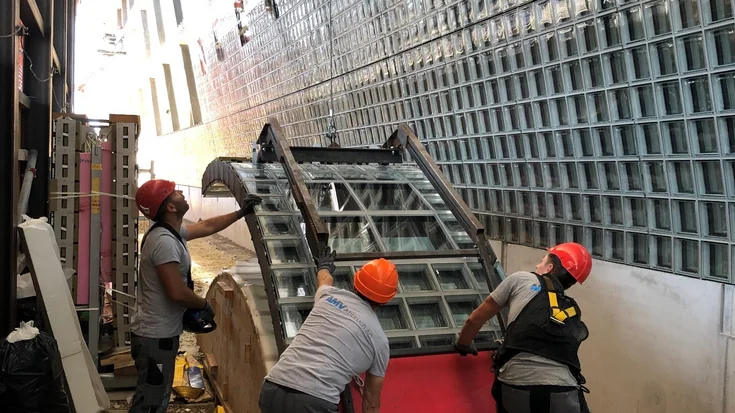

The complex geometric form and cramped conditions made installation of the glass brick faƧade particularly challenging. Elements were delivered to the site and then hoisted into their final position from a telescopic ladder inside the building, using special lifting frames. Various installation aids had to be developed to ensure the elements were positioned correctly during the lifting process.

All the elements are integrated into the building earthing through their suspension points; these form part of the concreted Halfen channels, which in turn have a metallic connection to the reinforcement. This makes it possible to discharge electric potential in the faƧade structure and provides lightning protection. This design also reduces the electrosmog resulting from the proximity to the train lines and their overhead wires, which generate powerful electric fields.

Summary

Glass bricks have a special aesthetic charm that comes to the fore in large-scale designs. However, their poor structural characteristics in comparison with other faƧade types have typically counted against them. The new faƧade developed by PORR for the Gleisarena office complex in Zurich represents a milestone in the use of the glass bricks for faƧade construction. As well as meeting the latest technical standards, the faƧade boasts a highly complex geometry. PORR is delighted to have had the opportunity to implement this faƧade structure, and the PORR employees have every right to be proud of the high-quality result.

Gallery
